Stopbanks banner image

Te Mahinga Ārai Waipuke o Waipaoa

Waipaoa Flood Control

Flood control climate change resilience project

In 2020 the government declared a climate change emergency, recognising the need for us all to prepare for the impacts of a warming climate, with more erosion, more flash floods and wildfires in our region.

Climate change is the most significant long-term issue facing our region. We’re expecting sea level rise, coastal erosion and floods affecting homes and recreation.

We need flood protection to keep our people and community safe from our rivers breaking their banks in heavy rains. We also need to ensure that our important horticulture, viticulture and farming assets are protected from the effects of climate change.

Council therefore wants to accelerate the delivery of our Waipaoa Flood Control Climate Change Resilience project, giving greater protection our community needs against floods, safeguarding both economic development and wellbeing.

The project aim is to increase the level of flood protection of the Waipaoa Flood Control Scheme (WFCS) up to a 100-year return period accounting for climate change effects out to the year 2090.

The WFCS comprises approximately 64km of stopbanks along the Waipaoa River, together with other river control structures and protection works (pipes, floodgates etc), built between 1953 and 1967 to provide flood protection to the Poverty Bay floodplains and Gisborne city.

Resource consent for stopbank improvement work was granted on 26 October 2018. Stopbank construction work first started in February 2019.

The original Waipaoa Flood Control Scheme was designed in 1949 and constructed between 1953 and 1969. It's considered to be one of Council’s most valuable assets and protects some 10,000 hectares of fertile floodplain land. Construction work to improve the scheme started in February 2019 and involves upgrading approximately 64km of stopbanks along the Waipaoa River by 2030/31.

Stopbank work

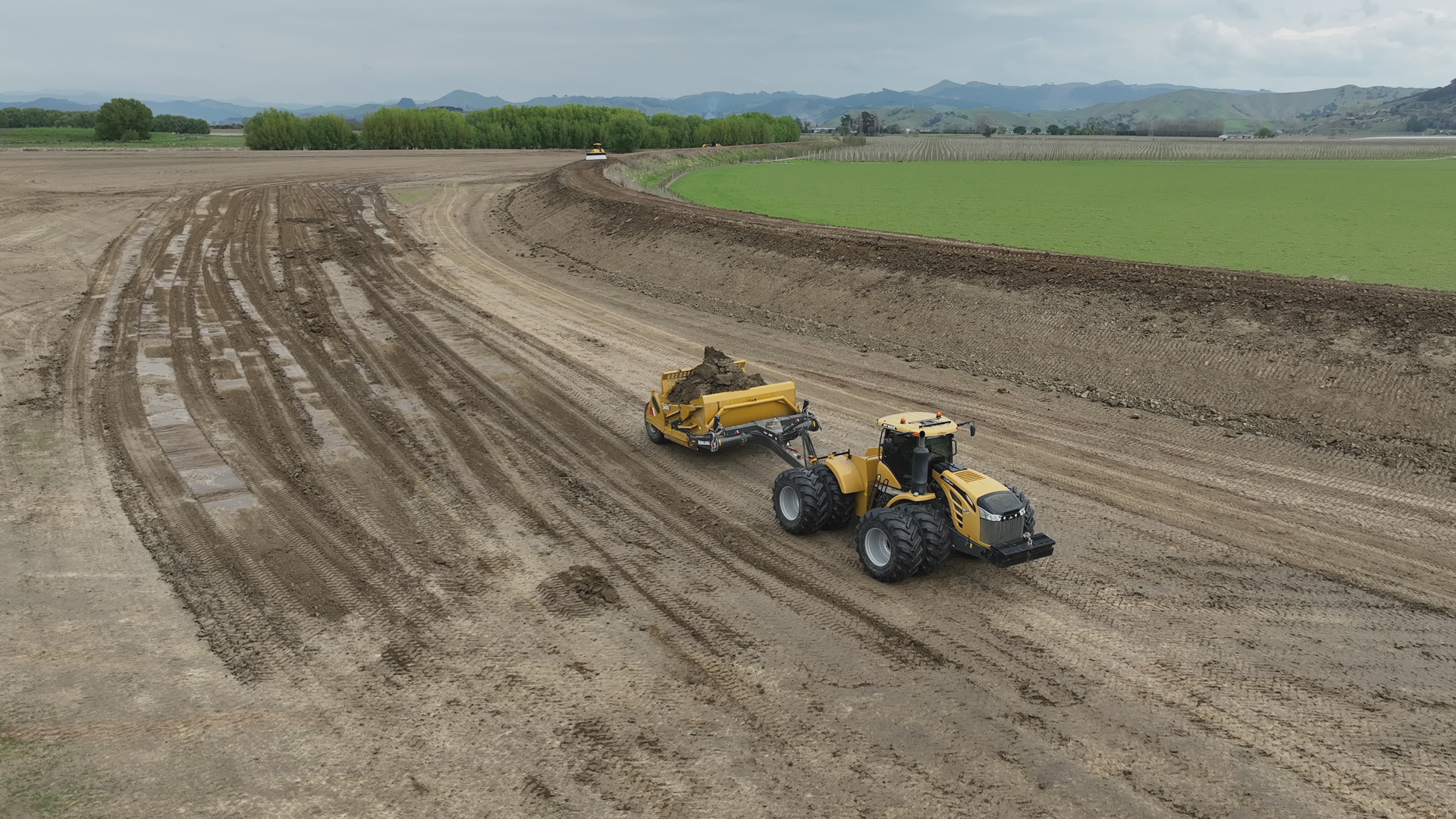

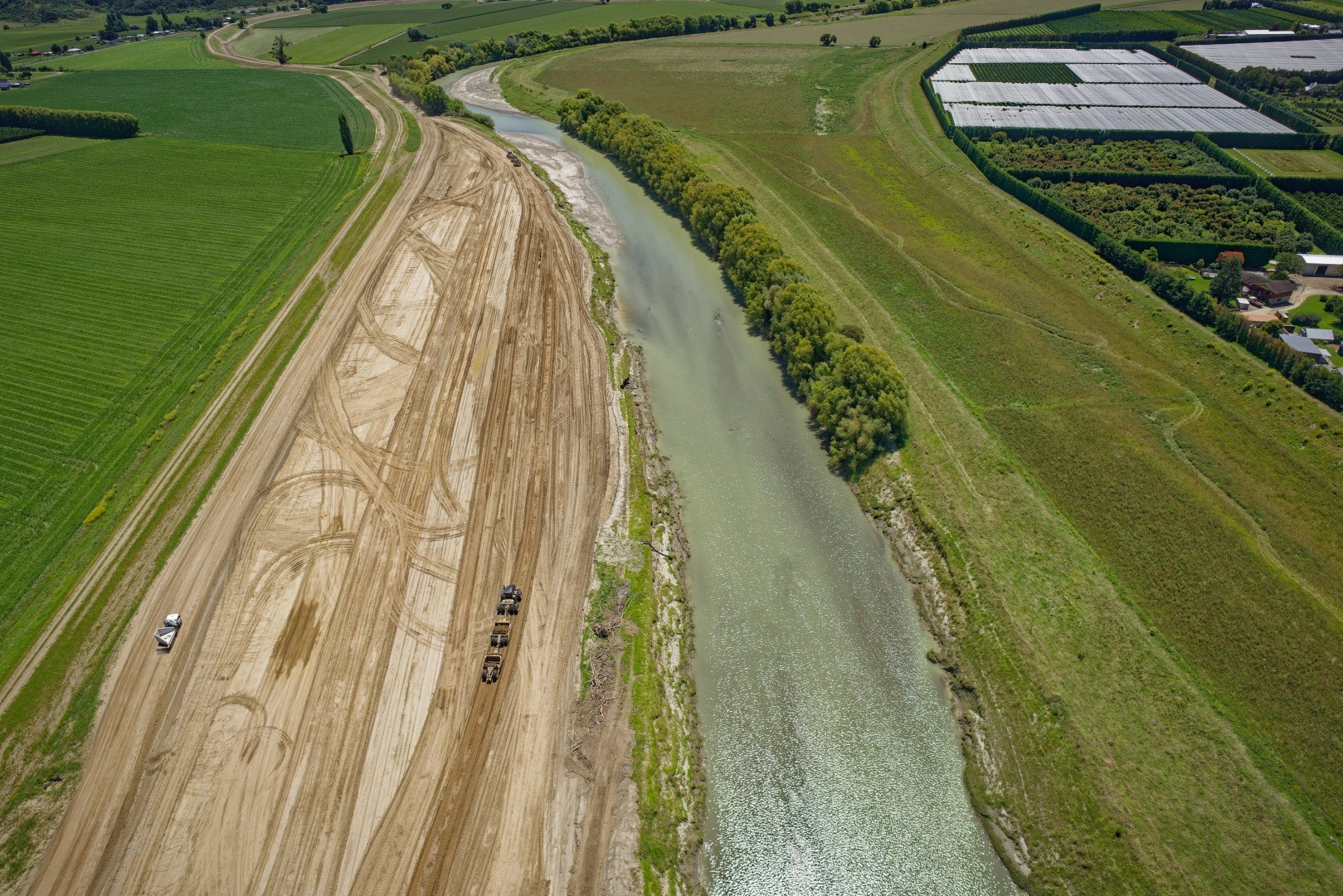

As well as making the stopbanks higher, construction work will widen the stopbank profile from the current 1.5m top crest to a 4m wide top crest. Stopbank heights are being increased by about 1-2 metres in some places.

Experts have told us higher and wider stopbanks are needed to provide the full level of protection we need.

Budget, where we're at

2023/24 Annual Plan budget $3,168,000.
2021-2031 Ten Year Plan budget $16,390,000.
External government funding $7,500,000.
Start date: 2015/16 Revised completion date: 2029/30
Overall project: Based on length of stopbank fully upgraded we're just over 50% through the project. Approx 34km of stopbank raising/widening has been completed.

Stopbank upgrade construction works well underway between Opou Road and the western side of Matawhero (SH2) Bridge. Works all occurring on the northern side of the Te Arai River between the Whatatuna Stream and SH2 Bridge near Manutuke.

Hydraulic modelling work is underway for the Waipaoa River near the Te Karaka township.

Contract award of the Kirkpatrick Road raising - contract to undertake road modifications to raise the existing road ‘low points’ located on either side of the Whakaahu up to the height of the upgraded Waipaoa stopbank.

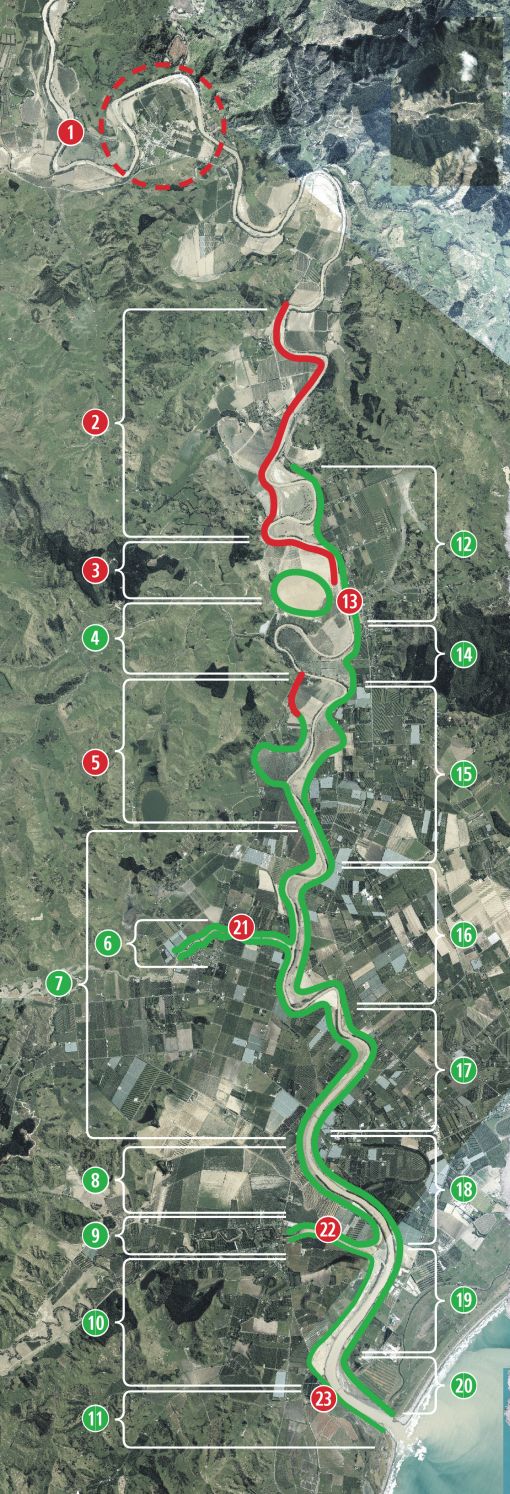

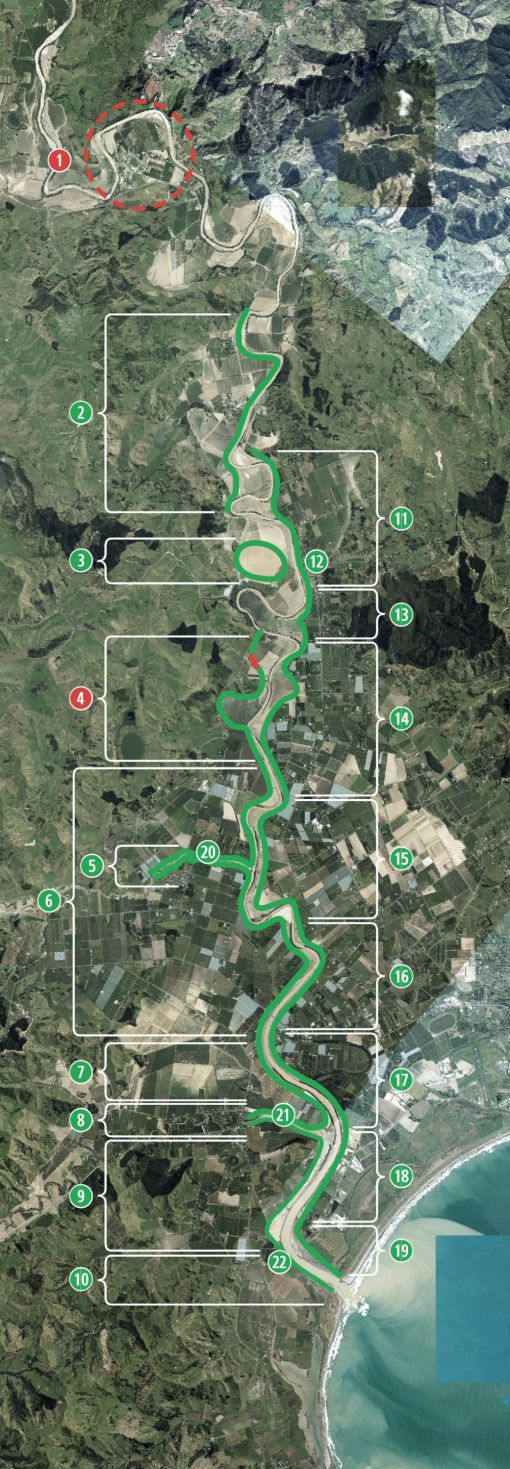

WFCS Construction Overview

Planned stopbank upgrade work

In August 2020, Council was awarded $7.5m of external funding support by Kanoa to accelerate the delivery phase of the project. This external funding reduces the financial contribution that the community has to pay towards the project. Funding expires January 2024.

Date planned Stopbank location
April – June 2023 Complete remaining stopbank upgrade on the eastern Side between Whitmore and Caesar Road.
April 2023 Start construction upstream from Opou Road working towards Matawhero SH2 Bridge.
October 2023 Complete remaining section at the Waipaoa River mouth downstream of railway bridge (western side).
October 2023 Complete remaining section between Whatatuna Floodgate to Manutuke Bridge.
October 2023 – June 2024 Upgrade between Matawhero (SH2) Bridge and Whakaahu Stream (western side).
October 2024 onwards Progressively upgrade the western side stopbanks until complete – from Whakaahu Stream working upstream.
2030/31 Waipaoa Flood Control Scheme fully upgraded and operational on both sides.

Total project cost estimate - $32-35 million

Completed stopbank upgrade, raised and widened (all located on eastern side)

Date completedStopbank location
February 2023Downstream from Opou Road to Whatatuna Floodgate fully upgraded - 2.2km
December 2022Between Waipaoa River mouth and Te Arai Stream (western side) except remaining 200m - 8.5km
April 2022Between Whitmore Road and Kaitaratahi Hill – 3km
March 2022Between Ford and Caesar Roads – 1km
February 2022Upstream of Matawhero SH2 bridge along eastern side to Ferry Road – 4.5km
May 2021Upstream of Matawhero SH2 bridge - 3km
March 2021Railway Bridge and Matawhero SH2 Bridge - 4km
December 2020Waipaoa River Mouth and Railway Bridge – 2km
February 2020Railway Bridge near Waipaoa river mouth – 2km
December 2019Between Bruce and Ferry roads - 2km
February 2019Between Ford and Bruce roads - 2.1km

Q&As for property owners along the Waipaoa River stopbank upgrades

The Waipaoa flood control climate change resilience project will:

  • Upgrade the existing flood control scheme to a 100-year design event including for climate change factors out to the year 2090.
  • Improve resilience against flood events.
  • Protect and improve council’s most valuable asset.
  • Continue to protect the 10,000 hectares of fertile floodplain land. This scheme protects and supports the high yield horticultural uses.

Earth fill material is required for the scheme upgrade. This will be sourced from a number of borrow sites located within the section that's being worked on each year. This is typically the flat floodable berm areas located between the stopbank and the river.

There'll be increased earthworks at these sites as borrow material is excavated and moved to the section of the stopbank that's being upgraded.

All borrow sites will be reinstated when construction is completed.

You may notice truck movements and noise from earthworks during construction.

You may also notice increased activity on sections of the scheme not under construction, as investigation and planning for subsequent construction phases is undertaken.

As the upgrades are completed, the stopbank will be re-sown with grass.

The upgrade work will generally be done during summer months when river flows are low and when there's favourable ground conditions.

Because the upgrade will affect parts of the flood control scheme as they're worked on, they'll be managed in limited sections at a time, to manage any potential flood risk.

If contractors require access to your property, we'll contact you.

The area required for access will be clearly shown on a plan and the term of access required clearly set out.

If you have a licence for any areas of the existing scheme which are being upgraded, you'll be contacted.

The timing of construction on any licenced area will be determined well in advance, so that any crop can be harvested and future plans made by the licensee.

There may be a reduction in the licence fee for any loss of use during the works. Once construction is completed, any changes to the licence will be discussed and a new license issued.

Where access is required to part of your property, a clearly defined area of entry will be agreed with you prior to any entry.

Any part of your property damaged by entry will be reinstated as close to its original condition as possible by the contractor on completion of the works.

There's no cost to the property owner or occupier for the work.  Those who wish to take advantage of reinstatement works and upgrade infrastructure such as fences may be able to pay the difference, assessed on a case-by-case basis.

Where the work affects an existing boundary fence, a temporary fence will be provided by the contractor to ensure any stock is kept secure. Once construction is complete, the fence will be fully reinstated by the contractor.

The contractor is required to manage dust and noise during the physical work.

Once construction's completed, the stopbank will be re-sown with grass.

Noise will be limited to earthworks machinery during construction.

Borrow sites for fill material to build the stopbanks will be selected to have the least environmental impact on river ecology, fish passage and spawning.

Cultural and archaeological discovery protocols have also been set up as part of the resource consent process in advance of construction occurring.

Work times will typically be 7am-7pm Monday to Friday and Saturday mornings 7am-1pm.

There will be no work on public holidays.

We will inform landowners who have a water take that crosses the stopbank about the timing of the work. The work will be managed to minimise disruption to the water supply during construction.

An 8km long cycle trail was completed in June 2022 between the Waipaoa River mouth and the Matawhero SH2 Bridge on the eastern side of the Waipaoa River. The resource consent for the cycle trail only covered this specific area. There is currently no approved resource consent for a cycle trail along any other stopbank.

Resource consent for the construction of any additional cycle trails along the Waipaoa stopbanks will be applied for on a case-by-case basis for specific sections as they are required. Council will consult with landowners and stakeholders as these cycle trail options are investigated and considered.
